What Time of Year Is Best to Replace a Roof

From Roofs Wiki

What Time of Year Is Best to Replace a Roof

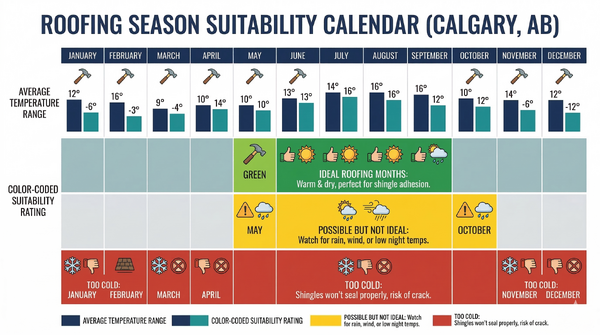

Seasonal calendar showing optimal temperature ranges for roofing work throughout the year
Seasonal calendar showing optimal temperature ranges for roofing work throughout the year

Best overall: Late spring through early fall (May through October in most regions).

While a roof can be replaced in virtually any season when necessary, the timing of your project affects material performance, contractor availability, pricing, and the overall quality of the installation. Understanding the seasonal tradeoffs helps you plan a replacement that gets the best results for your budget.

Why Warm Weather Is Ideal

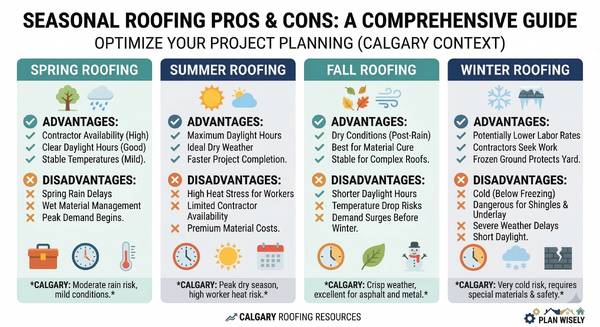

Chart listing the pros and cons of roofing in each season: spring, summer, fall, and winter
Chart listing the pros and cons of roofing in each season: spring, summer, fall, and winter

Shingle Self-Sealing

Asphalt shingles have a thermally activated adhesive strip on their underside. After installation, this strip must soften and bond to the shingle below to create a wind-resistant seal. The adhesive activates at temperatures between 40F and 70F (4C to 21C). In warm weather, shingles self-seal within days. In cold weather, the adhesive may not activate until the following spring, leaving shingles vulnerable to wind uplift for months.

Dry Working Conditions

Warm-season months offer more consecutive dry days for completing the project without interruption. Underlayment and decking should stay dry during installation. Rain delays mid-project leave the home temporarily exposed and can damage materials already on the roof.

Longer Working Days

Summer daylight extends to 14-16 hours in most regions, allowing crews to accomplish more per day. A roof that takes 2-3 days in summer may take 4-5 days in winter due to shorter working hours and weather delays.

Material Flexibility

Asphalt shingles are more pliable and forgiving in warm temperatures. They bend to conform to the roof surface, cut cleanly, and seal properly. In cold weather, shingles become stiff and brittle -- they crack during installation, break when bent over hips and ridges, and resist proper placement.

Peak Season (June Through August)

Pros:

  • Best weather conditions for installation
  • Materials perform optimally
  • Longest working days
  • Immediate shingle self-sealing

Cons:

  • Highest demand -- contractors are booked weeks or months in advance
  • Prices may be 10-20% higher due to demand
  • Extreme heat (100F+) can make roofing dangerous and can soften shingles excessively during installation
  • Scheduling is less flexible

Peak season is ideal for the installation itself, but you pay a premium for the timing. If your project can be scheduled during a shoulder season, you may save money without sacrificing quality.

The Sweet Spot (April-May and September-October)

Late spring and early fall offer the best overall value for roof replacement:

  • Weather is favorable -- warm enough for shingle sealing, cool enough for comfortable and safe working conditions
  • Contractor schedules are more open -- easier to book your preferred contractor and get a convenient timeline
  • Pricing may be more competitive -- less demand pressure on labor rates and material markups
  • Moderate temperatures are ideal for material handling and worker productivity

September and October are particularly popular with experienced homeowners who understand the seasonal dynamics. The summer rush has passed, good weather typically continues, and many contractors offer competitive pricing to fill their fall schedules before the winter slowdown.

Winter Replacement

Winter roof replacement is possible but not ideal. It should be reserved for emergencies where waiting for warmer weather is not an option.

Challenges:

  • Cold shingles are brittle and crack easily when nailed, bent, or stepped on
  • Adhesive strips will not activate until sustained warm weather arrives, leaving shingles vulnerable to wind for weeks or months
  • Shorter working days extend project duration
  • Weather delays are frequent and unpredictable -- snow, ice, and rain can halt work for days
  • Ice on surfaces creates dangerous conditions for crews
  • Material costs may not decrease despite being the off-season, because fewer contractors are competing

When winter replacement is necessary:

  • Storm damage that cannot wait until spring
  • Active leaks causing ongoing interior damage
  • Structural concerns that pose safety risks
  • Home sale closing deadlines that require a new roof

Contractors who work through winter typically charge a premium for adverse conditions and may require weather contingency clauses in the contract. If you must replace in winter, choose a contractor experienced in cold-weather installation who uses hand-sealing techniques on shingles (applying a dab of roofing cement under each shingle tab to compensate for the inactive adhesive strip).

Emergency Replacement

Regardless of season, emergency replacements should proceed as soon as possible. Storm damage, structural failure, and active leaks that threaten the home's interior cannot wait for ideal weather. In emergencies:

  • Have temporary tarping done immediately to prevent further damage
  • Contact your insurer promptly
  • Accept that emergency scheduling during adverse seasons will cost more
  • Prioritize the most damaged sections if a full replacement cannot be completed immediately

Regional Adjustments

The ideal timing varies by region:

Region Best Replacement Window Notes
Northern US / Canada June - September Short warm season; September is ideal sweet spot
Southern US March - May, September - November Avoid peak summer heat; extended warm season allows flexibility
Pacific Northwest July - September Dry season is short; book early
Desert Southwest October - April Avoid extreme summer heat (120F+ surface temps)
Coastal / Hurricane November - May Avoid hurricane season (June-November)

Planning Timeline

For the best experience, begin planning 3 to 6 months before your target installation date:

  1. Research materials and contractors (3-6 months out)
  2. Get multiple quotes (2-4 months out) -- see How to Choose a Roofing Contractor
  3. Sign contract and order materials (1-2 months out)
  4. Installation during your target window

Last-minute scheduling, especially in peak season, limits your contractor options, negotiating leverage, and material choices.
